Cooperative Plaza’s building modernization project is part of a long-term plan to enhance building infrastructure and create a more modern and comfortable environment for all tenants, their staff, clients and customers. We look forward to providing you with a more modern building designed to meet your growing needs.
Construction is currently scheduled to start on January 12.*
*Start date contingent on obtaining required permits.
Scope of Work
- A new amenity suite in 4401 Wilson Boulevard (already in progress).
- Updates to the facade of the buildings, including the removal of the covered breezeway.
- An updated conference center and lobby for 4301 Wilson Boulevard.
- An updated lobby for 4401 Wilson Boulevard.
- An updated fitness center at 4401 Wilson Boulevard.
- Updated elevator cabs in both buildings.

Frequently Asked Questions
We are committed to providing clear and concise communication throughout the construction process. Below are answers to commonly asked questions. If you do not see the answer to your question below, you can contact Brad Smith by email at Brad.Smith@nreca.coop, or by phone at 703-907-5934.
What is the capacity for the new amenity suite in 4401 Wilson Boulevard?
The new Amenity Space (which will be ready/available in early 2026) will have 3 conference rooms:
- 1 Medium Room
- This room has a fixed conference table that will seat 10 people
- 2 Large Rooms that will have an Operable Partition to combine the rooms. Additionally, the furniture will allow for different configurations. Below are the various capacities by configuration:
- Each large room (Table): 16
- Each large room (Classroom): 18
- Combined large rooms (Boardroom): 32
- Combined large rooms (Classroom): 40
- Combined large rooms (Lecture): 76 (code maximum)

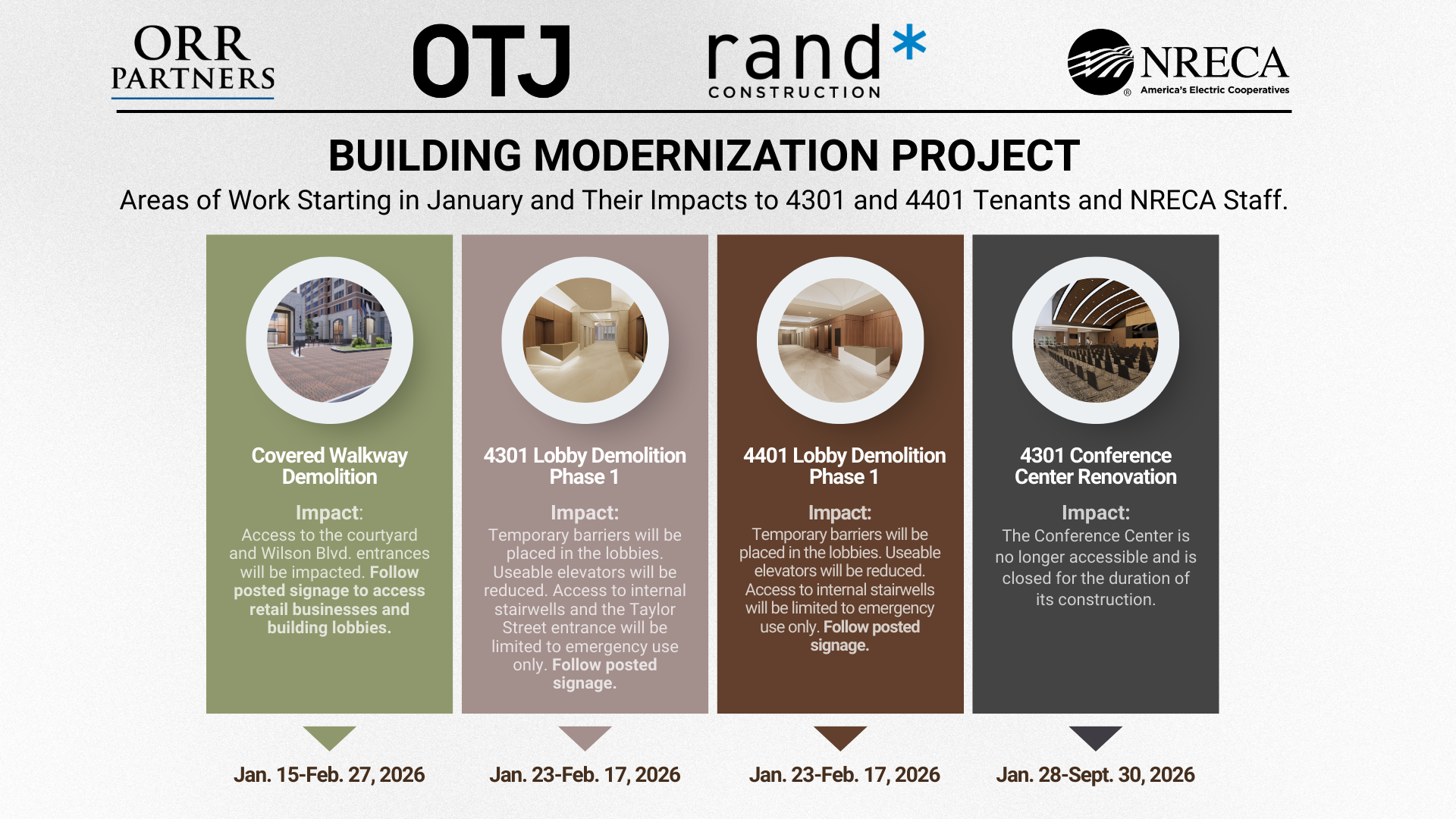

January Project Timeline
